Huong Linh 3–4 Wind Power Project

PPL specializes in providing oversized and overweight transportation solutions for industrial, energy, infrastructure construction, and machinery manufacturing projects. With over 5 years of experience handling goods exceeding standard dimensions and weight limits, we guarantee safety, accuracy, and timely delivery.

huong-linh-6

Goals & Scope of Work

The Huong Linh 3-4 Wind Power Plant project is being implemented to supplement the power supply for the Central region, reduce pressure on the national power grid, and meet the electricity consumption needs of the people. In addition, the project effectively exploits the economic potential of renewable energy, creating momentum for socio-economic development and poverty reduction in the mountainous district of Huong Hoa, while contributing to the economic growth of Quang Tri province.

Key Challenges

  1. Wind turbine equipment falls under the category of oversized and overweight cargo, requiring specialized vehicles for safe transportation.
  2. The transportation route from the port to the construction site is long, with complex and treacherous terrain, posing significant coordination challenges.
  3. The tight timeframe necessitates synchronization between multiple components to ensure construction progress.

Solutions & Deployment

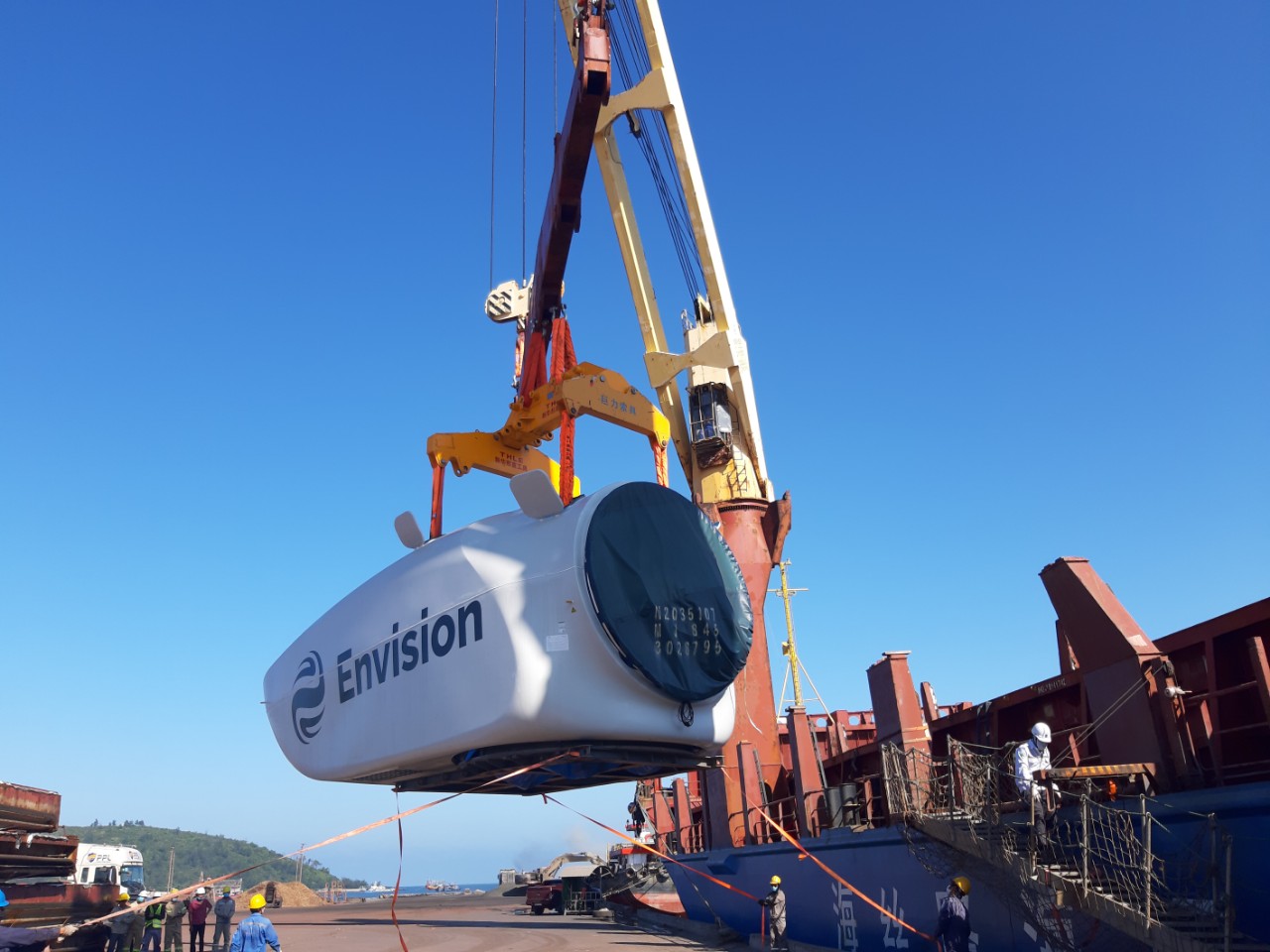

With extensive experience in oversized and overweight cargo transportation, a strong network of relationships with port systems, and a fleet of internationally standardized vehicles and equipment (90% newly imported), Bao Tin Trading & Logistics Co., Ltd. (PPL) successfully transported all wind power equipment for the Huong Linh 3-4 project.

Notably, PPL invested in building its own warehouse for the project – a solution that very few domestic logistics companies are capable of implementing – to optimize progress, enhance safety, and improve transportation quality.

Project Overview

Investor/Partner of PPL

Huong Linh 3-4 Wind Power Joint Stock Company / Rongtua Corp

Services Provided

Transportation and Customs Clearance

Transportation Distance

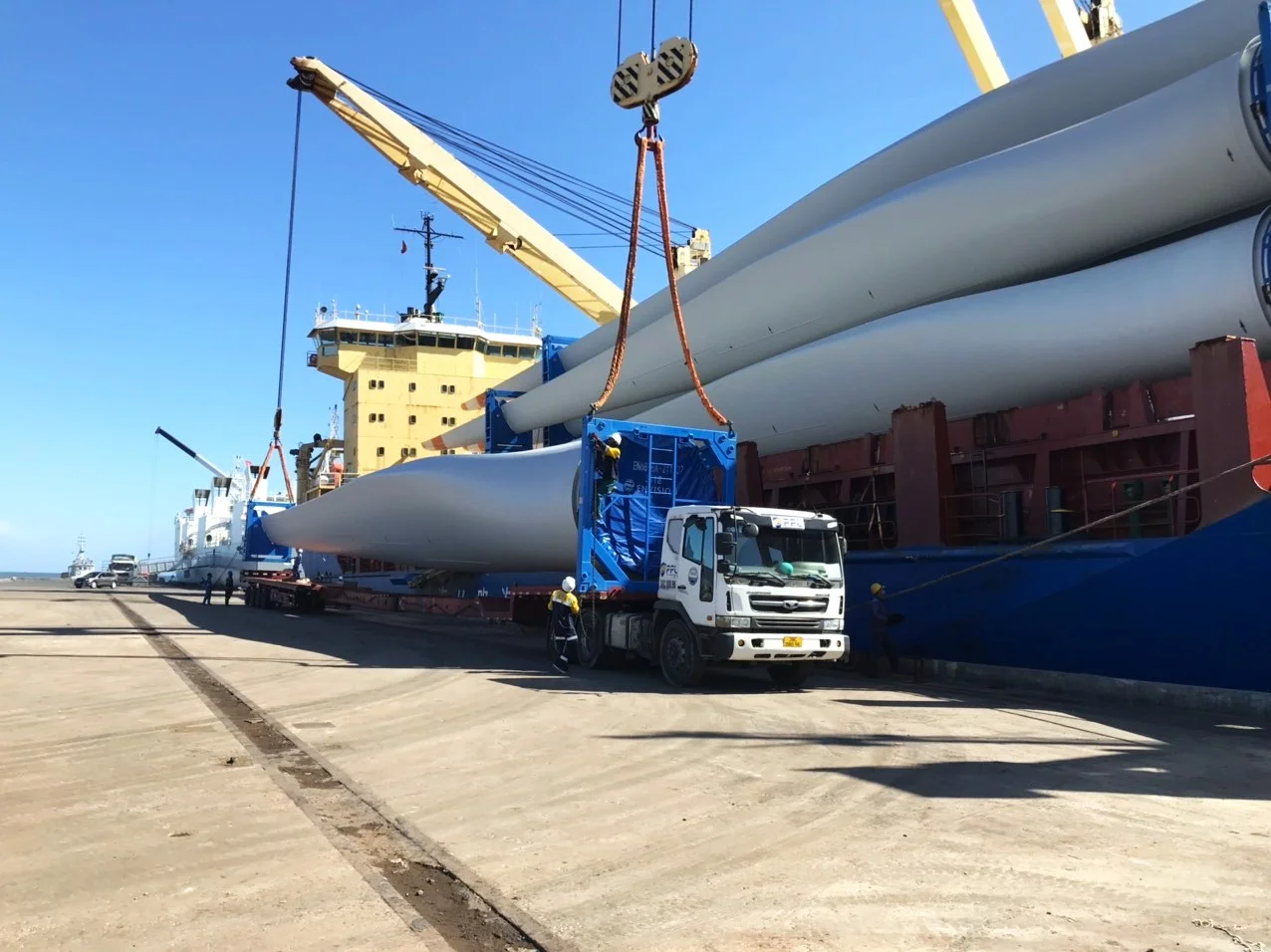

202 km (Hon La Port to construction site)

Quantity

19 wind turbines

Heaviest/Longest Package

87.7T/70 m

Transportation Time

From May 2021

Results & Effectiveness

The project was transported and delivered on schedule and with absolute safety, contributing to the stable operation of the Huong Linh 3-4 Wind Power Plant. This success not only affirms PPL's ​​role as a reliable partner in the renewable energy sector but also demonstrates its commitment to accompanying localities in sustainable socio-economic development.

Notice
