Amaccao Wind Power Project

PPL is responsible for transporting and customs clearance of 12 wind turbine towers for the Amaccao Quang Tri 1 project – one of the largest and heaviest equipment projects in Vietnam, requiring safe and timely oversized and overweight transportation solutions.

2-2-2

Goals & Scope of Work

The Amaccao Quang Tri 1 Wind Power Plant project was implemented to exploit the renewable energy potential of the Central region, contributing to reducing the burden on the national power grid and promoting local socio-economic development.

PPL was entrusted by the Amaccao Group with the task of transporting and customs-clearing all project goods, including oversized and overweight equipment such as wind turbine towers, blades, and auxiliary components.

Key Challenges

  1. The heaviest piece of oversized and overweight equipment weighed 103 tons and measured 76.2 meters in length.

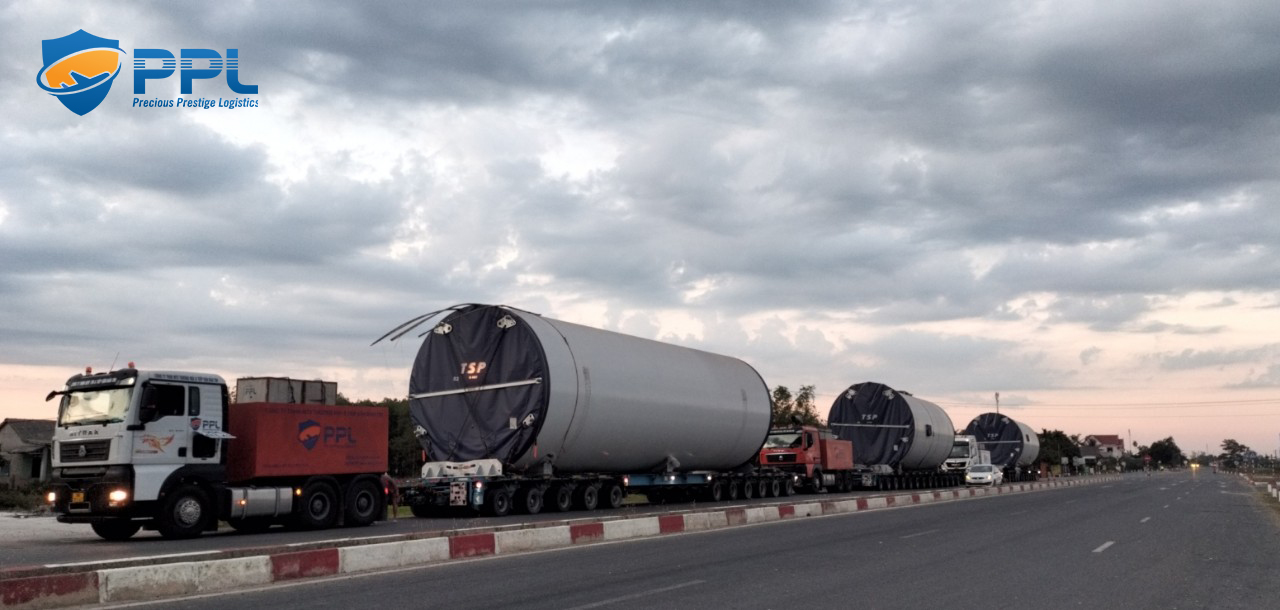

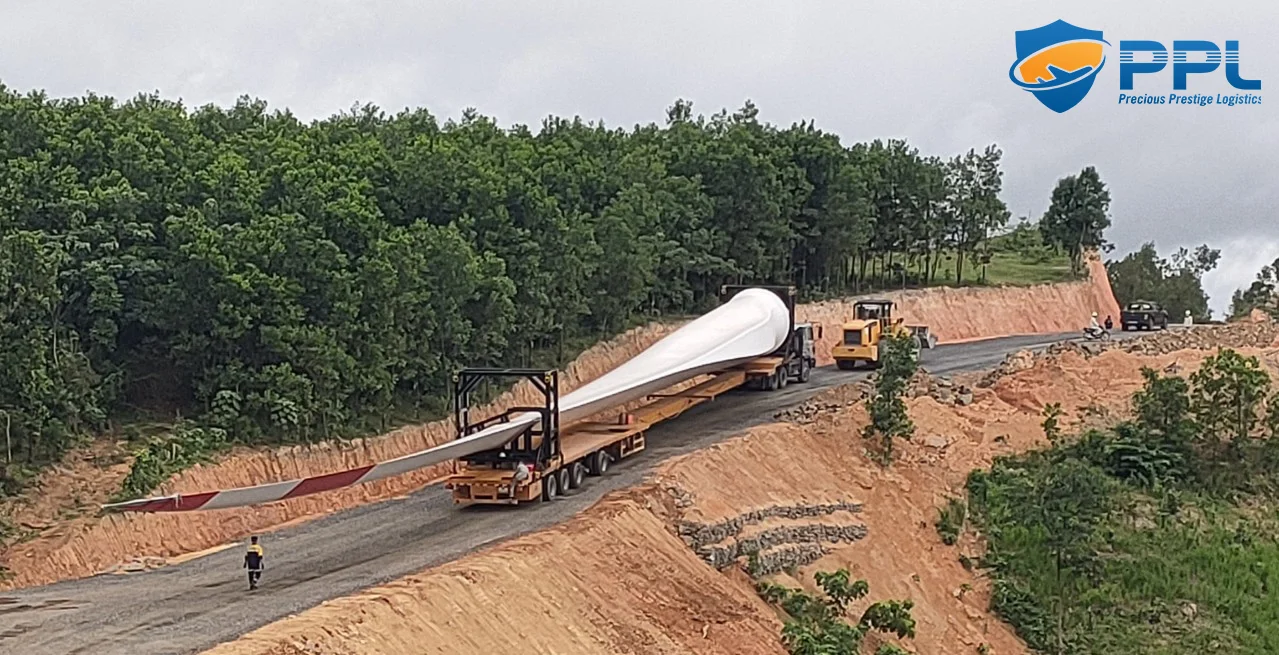

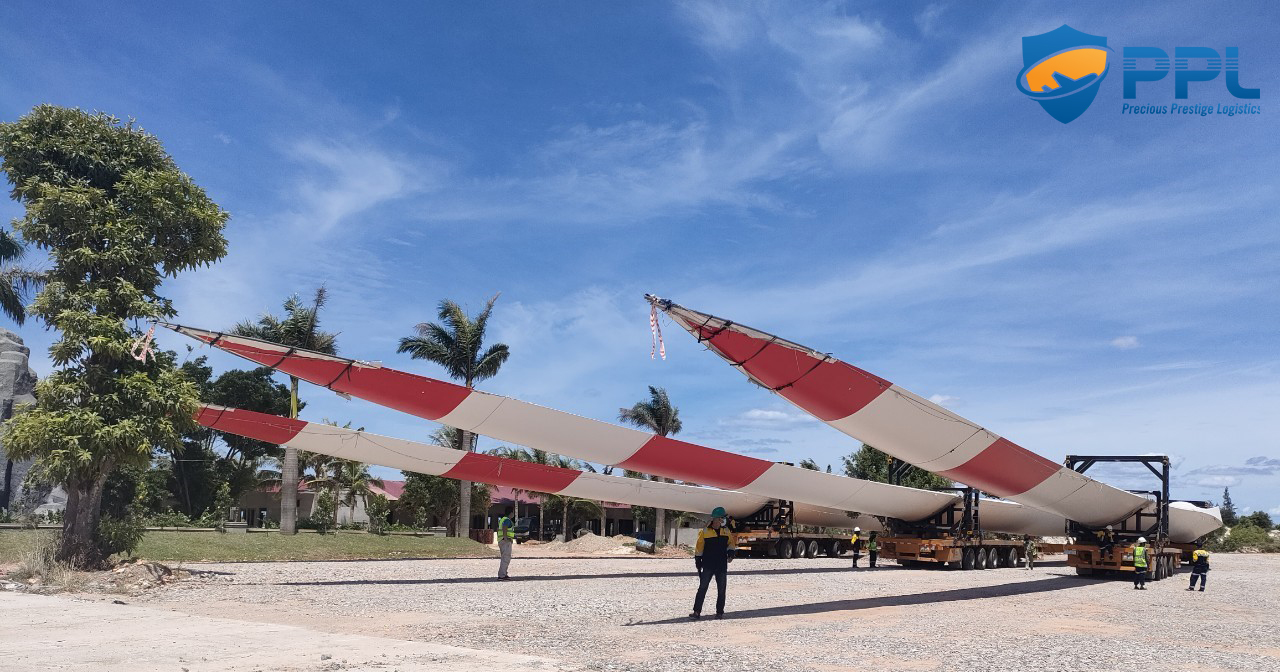

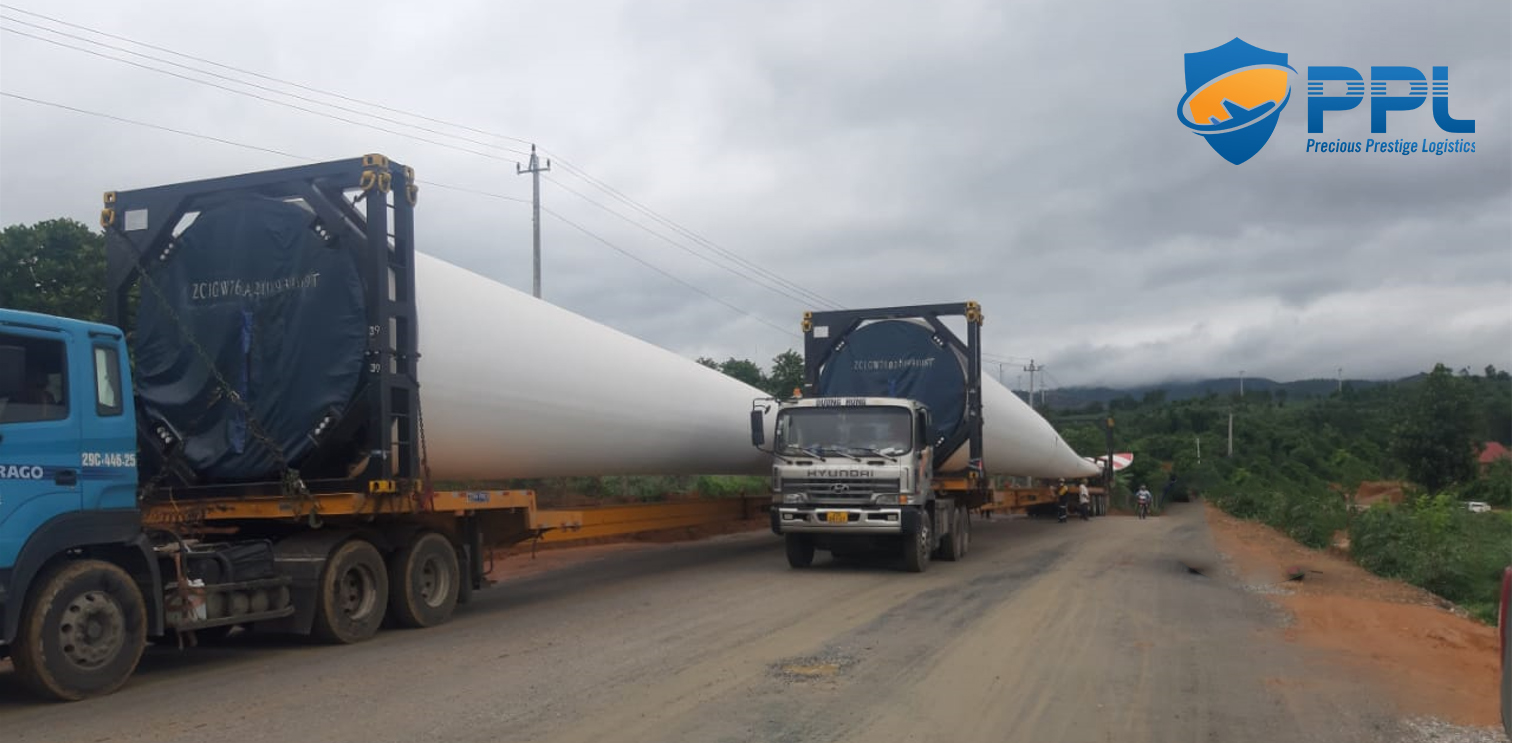

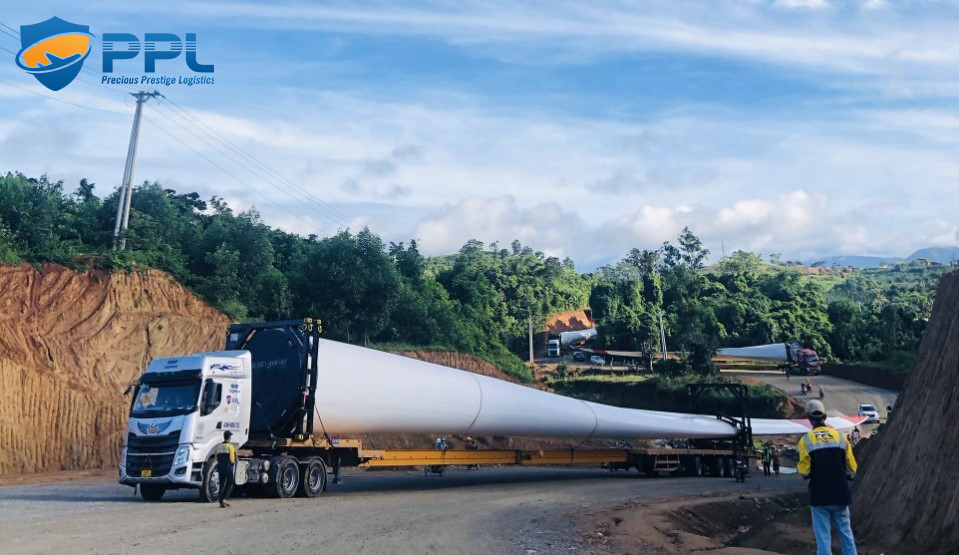

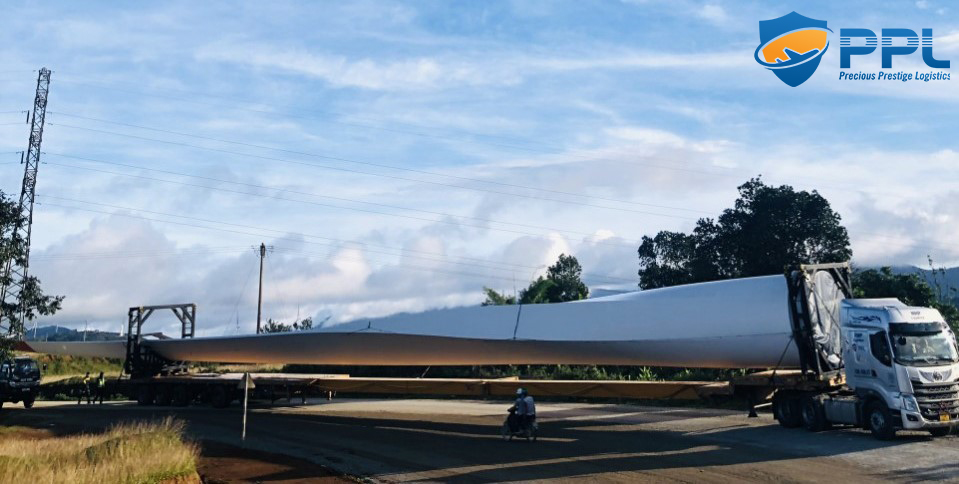

  2. The hilly and winding terrain of the Central region, along with the 245 km distance, posed significant transportation challenges.
  3. Stormy weather, disease outbreaks, and tight deadlines greatly impacted the construction process.

Solutions & Deployment

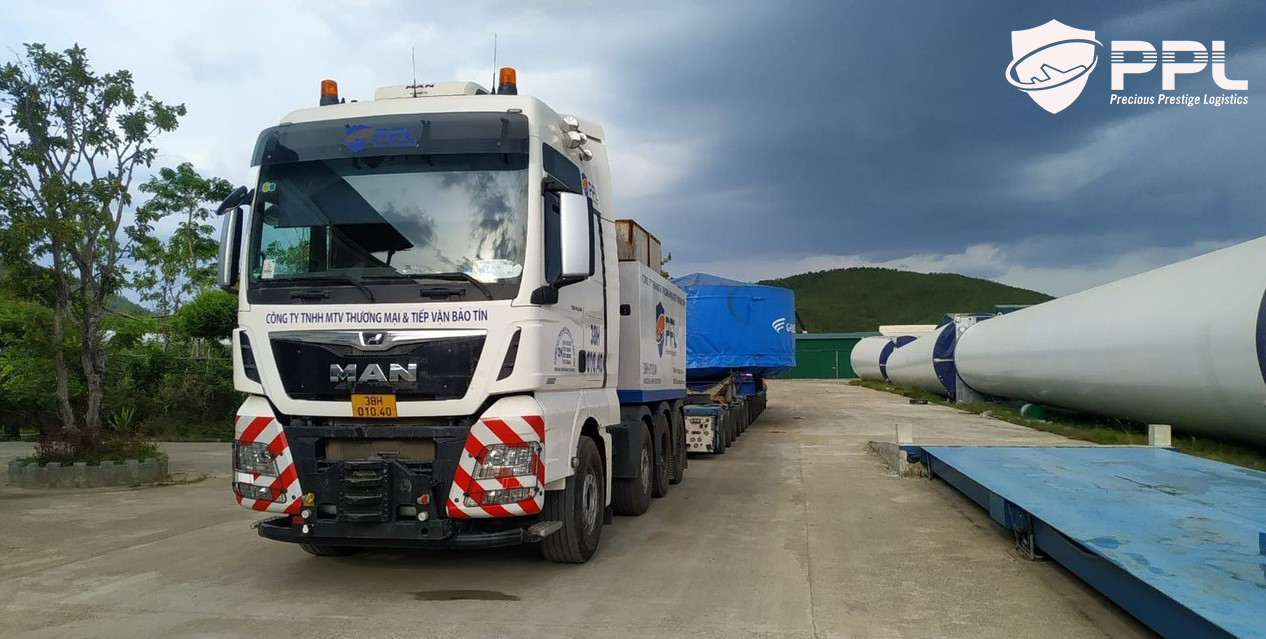

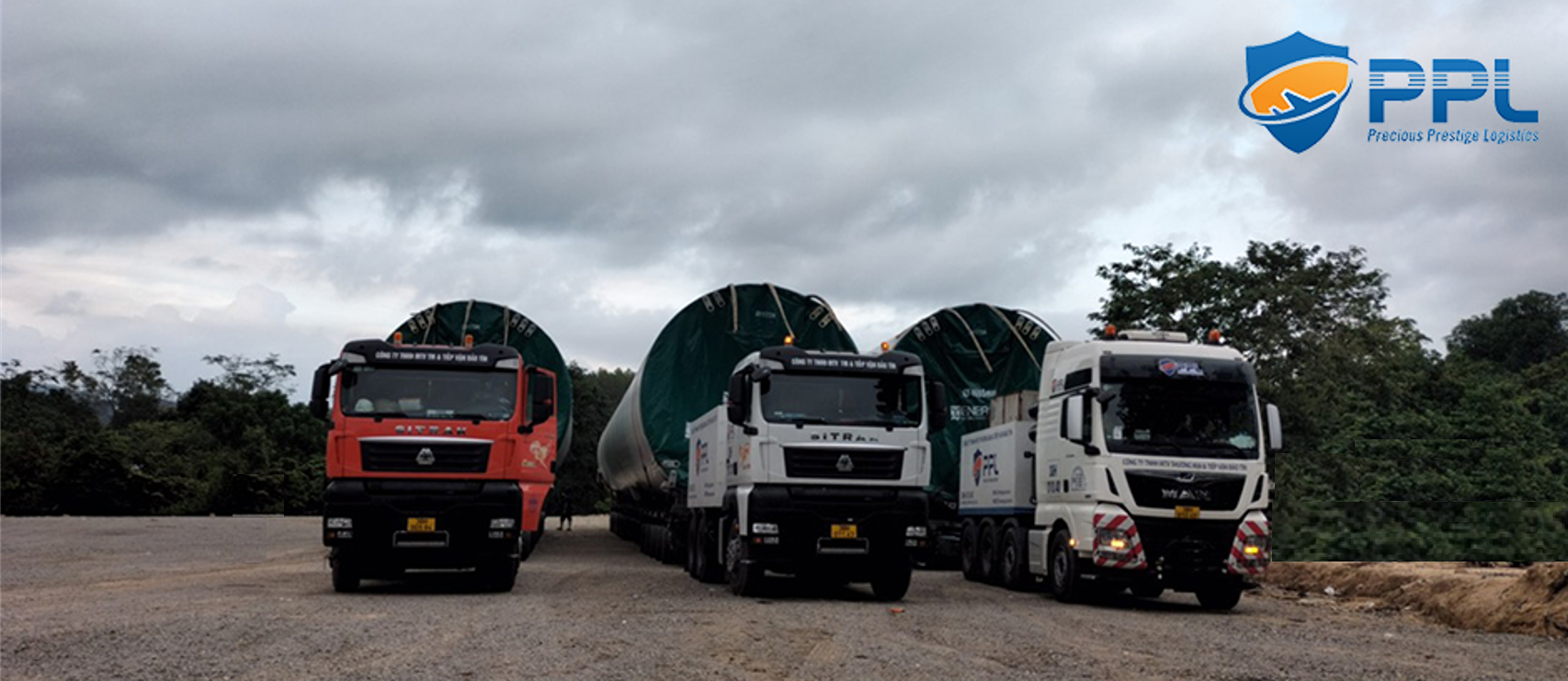

  1. PPL has mobilized a modern fleet of oversized and overweight vehicles, 90% of which are newly imported, meeting international standards for safety and load capacity.
  2. At the same time, PPL's ​​team of engineers and specialists have:
  • Developed detailed route plans and thoroughly surveyed each section of the terrain.
  • Arranged flexible staffing and implemented continuous day and night transportation to meet deadlines.
  • Strictly implemented disease prevention procedures, ensuring the health and safety of all employees during the pandemic.

Project Overview

Investor

Amaccao Group

Services Provided

Transportation and Customs Clearance of Goods

Quantity of Goods

12 wind turbine towers

Heaviest Cargo

103 tons

Most Oversized Cargo

76.2 m

Transportation Distance

245 km (Hon La Port to Construction Site)

Execution Time

From June 2021 to August 2021

Results & Effectiveness

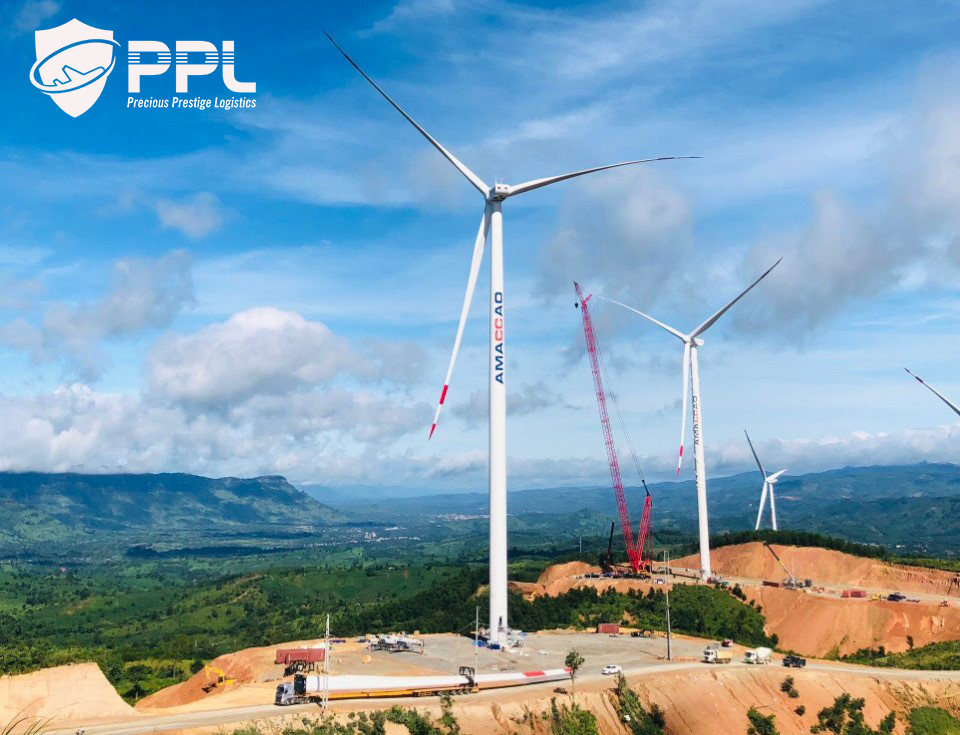

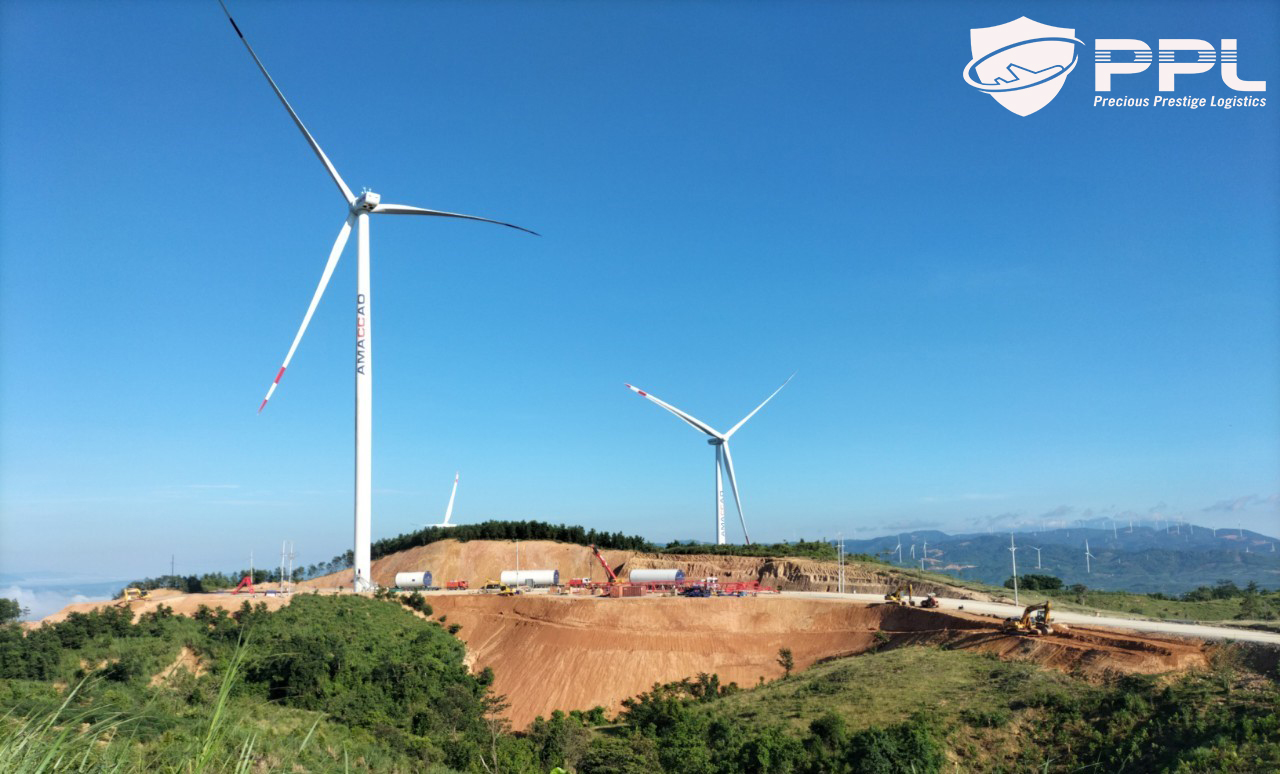

The project was completed with absolute safety, on schedule, and to the highest technical standards.

The success of the Amaccao Quang Tri 1 project not only affirms PPL's ​​oversized and overweight transport capabilities but also contributes to promoting the development of the renewable energy sector in Vietnam, while demonstrating PPL's ​​commitment to partnering with partners and localities for sustainable development.

PPL completed the transportation of 12 wind turbine towers for the project within 30 days.
